Insight · Industry Report
Syringe Factory Feasibility Study | NovalineX
A syringe factory feasibility study is the foundation of any bankable syringe manufacturing project. For investors, plant owners and project managers planning a disposable or safety syringe plant, the

Key Takeaway
A syringe factory feasibility study is the foundation of any bankable syringe manufacturing project. For investors, plant owners and project managers planning a disposable or safety syringe plant, the
Syringe Factory Feasibility Study — Investment & Design Guide
Section 02
Introduction
A syringe factory feasibility study is the foundation of any bankable syringe manufacturing project. For investors, plant owners and project managers planning a disposable or safety syringe plant, the feasibility study is how risk is quantified, costs are validated and finance-level project packages are created. This guide explains the components of a professional feasibility study, technical requirements for GMP-compliant production, realistic cost and ROI frameworks, common mistakes and NovalineX recommendations for turnkey, bankable project delivery.
This article is written for decision makers who need a practical, engineering-led roadmap to move from concept to funded project. It includes actionable checklists, a comparative cost table, and the questions you must answer before committing to equipment orders or land acquisition.
Section 03
Industry Background
Global demand drivers
- Growing immunization programs, insulin therapy, diabetes prevalence and expanded global healthcare access are increasing demand for single-use syringes.
- Regulatory emphasis on safety syringes and auto-disable designs is creating premium product segments with higher margins.
- Local manufacturing incentives in many emerging markets reduce import dependence and favor domestic production.
Market dynamics and competition
- The syringe market is price-sensitive for commodity disposable syringes and differentiated for safety/auto-disable types.
- Vertical integration (e.g., molding + assembly + packaging) provides margin advantages but requires larger capital and technical capability.
- Speed-to-market matters: factories that can validate GMP quickly and offer consistent quality capture long-term supply contracts.
Regulatory and quality environment
- GMP compliance, ISO 13485 for medical devices and country-specific regulatory approvals are prerequisites for selling to public tenders and large health systems.
- Documentation, traceability and validation protocols established at feasibility stage reduce rework during plant qualification and regulatory inspection.
Key takeaways for investors
- Understand product mix: commodity disposable vs safety syringes changes equipment, cleanroom classification and costing.
- Regulatory readiness and validated supply chains are major value drivers for a bankable project.
Section 04
Project Scope
Defining the scope correctly in a syringe factory feasibility study determines the accuracy of cost estimates, timelines and bankability. Typical scope items include:
- Product portfolio: standard disposable syringes, auto-disable, safety syringes, prefilled syringes.
- Annual capacity target: units per year, with phased ramp plan (month-by-month for year 1, year 2 and year 3 projections).
- Degree of vertical integration: in-house molding, in-house syringe assembly, or sourced components.
- Regulatory target markets: domestic sales, regional export, WHO prequalification or CE marking.
- Delivery format: bulk packaging for hospital supply, hospital ready packs, sterile blister packs, or prefilled injectors.
Scope checklist for the feasibility study
- Market demand assessment and contract pipeline analysis.
- Site assessment including utilities, logistics, and expansion potential.

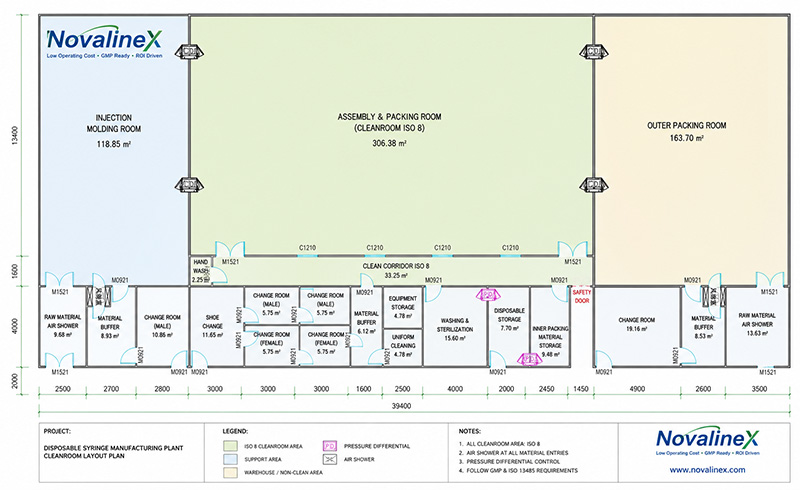

- Process flow diagrams and layout concepts for GMP-compliant cleanrooms.
- Equipment list with vendor options, CAPEX and delivery timelines.
- Operating cost model with labor, utilities, raw materials and maintenance.
- Environmental, health and safety (EHS) and waste management plan.
- Regulatory pathway and validation timeline (IQ/OQ/PQ milestones).
- Financial model: CAPEX, OPEX, working capital, sensitivity analysis and IRR / payback.
Role of the study in procurement and financing
A bankable syringe factory feasibility study is used to:
- Secure construction and equipment financing by demonstrating realistic cash flows and risk mitigation.
- Shortlist turnkey suppliers who can deliver GMP factory design and validated production lines.
- Provide a basis for contracts with raw material suppliers and equipment manufacturers.
Process Timeline
Technical Considerations
- 1
R
- 2
I
- 3
S
- 4
S
- 5
P
Comparison
Cost Analysis
This section provides a framework for CAPEX and OPEX estimates typically included in a syringe factory feasibility study. All figures below are indicative; project-specific quotes are required for bankable conclusions.
Capital expenditure (CAPEX) categories
- Land and site development
- Civil works and cleanroom construction
- Equipment procurement (molding presses, assembly lines, sterilization, packaging)
- Utilities and infrastructure (HVAC, compressed air, steam, power distribution)
- Validation and qualification costs
- Project management, engineering and contingency (typically 10-20% of hard costs)
Operating expenditure (OPEX) categories
- Raw materials and consumables
- Labor and benefits
- Utilities (electricity, water, gas)
- Maintenance and spares
- Sterilization and waste handling costs
- Quality control and laboratory expenses
Comparison table: Typical CAPEX and OPEX ranges by factory configuration
| Item | Small (5–10M units/yr) | Medium (25–50M units/yr) | Large (100M+ units/yr) |
|---|---|---|---|
| Total CAPEX (USD) | 2.5M–6M | 10M–25M | 30M–80M |
| Equipment share of CAPEX | 40–55% | 45–60% | 50–65% |
| Annual OPEX (USD) | 1.0M–3.0M | 3.5M–8.0M | 10M–30M |
| Raw material as % of OPEX | 40–60% | 45–60% | 45–60% |
| Typical payback (years) | 3–6 | 3–7 | 4–8 |
Notes on table: ranges depend on product mix, degree of automation, sterilization method and local labor costs. Small plants often rely on manual assembly and lower automation; large plants invest heavily in automation to reduce per-unit labor costs.
Key cost drivers and levers
- Degree of automation: higher front-loaded CAPEX but lower per-unit labor costs and greater yield.
- Sterilization approach: in-house EtO or gamma sterilization adds CAPEX and regulatory burden but reduces per-unit logistics costs; contract sterilization reduces CAPEX but increases OPEX and lead times.
- Vertical integration: in-house molding increases CAPEX but reduces component supply risk and long-term cost volatility.
- Location: proximity to utilities, logistics hubs and skilled labor materially affects OPEX.
Sensitivity and contingency
- Sensitivity analysis should model raw material price swings (especially medical-grade polypropylene), utility cost inflation and potential delays in regulatory approvals.
- Contingency budget should be allocated separately for foreign exchange exposure on imported equipment and for escalation on long lead-time items.
Section 07
ROI Analysis
A rigorous ROI analysis converts the technical and cost data into investor metrics that banks and equity partners will use to decide. The feasibility study should present base, upside and downside scenarios.
Key financial metrics
- Net Present Value (NPV)
- Internal Rate of Return (IRR)
- Payback period (cash payback)
- Break-even utilization (units per month required to cover fixed costs)
Model inputs and assumptions
- Capacity utilization ramp: conservative estimate for year 1 (e.g., 40–60% of nameplate), reaching target by year 2–3 depending on sales contracts.
- Realistic pricing: warranty for sales contracts, tender prices, and expected mix of higher-priced safety syringes.
- Working capital assumptions: raw material lead times, inventory days, receivable days for customers including government tenders.
- Tax incentives: local production incentives, export rebates or reduced import duties on certain inputs.
Scenario analysis example (illustrative)
- Base case: 50M units/yr, blended price USD 0.03/unit, gross margin 35%, CAPEX 15M, OPEX 5M/yr — IRR 18% (assumes conservative ramp and existing sales contracts).
- Upside: secured 5-year supply contract at premium price for safety syringes and reduced raw material cost through vertical integration — IRR >25%.
- Downside: delayed approvals and lower-than-expected tender wins, 60% facility utilization — extended payback and depressed IRR.
Break-even analysis
- Calculate fixed costs (depreciation, admin, fixed utilities) and contribution margin per unit. Break-even units = fixed costs / contribution per unit.
- Use this to set minimum order commitments needed from anchor customers or tenders.
Financing structure and repayment
- Typical project finance combines equity (25–40%) and debt (60–75%). A bankable feasibility study demonstrates cashflows sufficient to service debt under stress scenarios.
- Debt covenants commonly require minimum DSCR (debt service coverage ratio) of 1.2–1.4.
Value drivers for buyers and lenders
- Anchor contracts, validated equipment and reliable suppliers reduce revenue and execution risk.
- GMP-ready design, documented validation plan and experienced operations team increase bankability and lower perceived risk.
Risk Watch
Common Mistakes
Risk · 01
The feasibility stage often reveals decisions that, if made incorrectly, create costly delays. Common mistakes include:
Risk · 02
Underestimating regulatory timelines
Risk · 03
Treat approvals and validation time as critical path items. Failure to plan for IQ/OQ/PQ can delay commercial operations by months.
Risk · 04
Incomplete utility sizing
Risk · 05
HVAC, compressed air and power undersizing leads to production bottlenecks after installation.
Risk · 06
Poor scope definition on product mix
Risk · 07
Designing for commodity syringes but later switching to safety syringes requires rework of assembly lines and often different sterilization.
Risk · 08
Ignoring spare parts and serviceability
Risk · 09
Not budgeting for spare parts and preventive maintenance increases downtime risk and OPEX volatility.
Risk · 10
Overlooking documentation needs for bankability
Risk · 11
Lenders require detailed EPC/Equipment contracts, validated cost estimates, and milestone-linked disbursement plans.
Risk · 12
Selecting suppliers only on price
Risk · 13
Lack of supplier validation and track record leads to delivery delays, quality shortfalls and missed validation criteria.
Risk · 14
Mitigation checklist
Risk · 15
Create a validation timeline with buffer and link procurement milestones to finance drawdowns.
Risk · 16
Procure HVAC and utility equipment based on equipment vendor input; include redundant capacity for critical systems.
Risk · 17
Lock product mix and packaging specifications before equipment orders.
Risk · 18
Include a service agreement and spare parts kit with equipment procurement.
Process Timeline
NovalineX Recommendations
- 1
S
- 2
C
- 3
P
- 4
C
- 5
I
- 6
S
- 7
I
- 8
P
FAQ
FAQ
Section 11
Conclusion
A syringe factory feasibility study bridges technical engineering, regulatory readiness and financial modeling to produce a bankable roadmap for investors and project teams. Correctly scoped studies de-risk projects by aligning product strategy, GMP design, equipment selection and finance-ready documentation. The most successful projects combine modular production planning, validated suppliers, staged commissioning and strong anchor contracts or confirmed demand.
By investing time and expert resources at the feasibility stage, you reduce execution risk, compress time-to-market and create the documentation lenders require to provide favorable financing terms.
Section 12
Call To Action
If you are planning a disposable or safety syringe manufacturing project, request NovalineX's bankable project package or schedule a feasibility consultation. Our turnkey solutions include GMP factory design, validated production lines, cost calculators and ROI roadmaps tailored to your target markets. Contact NovalineX to start a feasibility study that lenders will accept and operations teams can execute.
Bankable Project Package for syringe factory feasibility
Project Questionnaire for syringe factory feasibility
Syringe Production Cost Calculator for syringe factory feasibility
Low Operating Cost Syringe Factory for syringe factory feasibility
About NovalineX
NovalineX helps investors develop bankable medical manufacturing projects across Africa, the Middle East, Asia, and emerging markets.
Interested in developing a medical manufacturing project?
Contact NovalineX for a preliminary project assessmentServices include
- Syringe Manufacturing Plants
- IV Solution Production Facilities
- Blood Collection Tube Projects
- GMP Planning
- ISO 13485 Compliance Support
- ROI & Feasibility Analysis
- Utility & Factory Layout Review
Next Step · Move Your Project Forward
Ready to advance your syringe factory project to bankable stage?
NovalineX delivers full bankability assessments, PPR preparation, GMP facility design, and turnkey production line execution — tailored to your market, scale, and financing plan.
